Unified Enterprise Resource Planning (ERP) Project
Kennesaw State University is taking part in the Unified Enterprise Resource Planning (ERP) Project, a major initiative across the University System of Georgia to upgrade and unify the systems we use every day. This project will replace current institutional legacy systems for Human Capital Management and Financials (such as PeopleSoft and OneUSG) with a new integrated system, Workday ERP. This will streamline core business processes, improve reporting, and increase collaboration and efficiency across all institutions within the university system.
To receive updates regarding ERP, sign up for our communications below!

Project Timeline

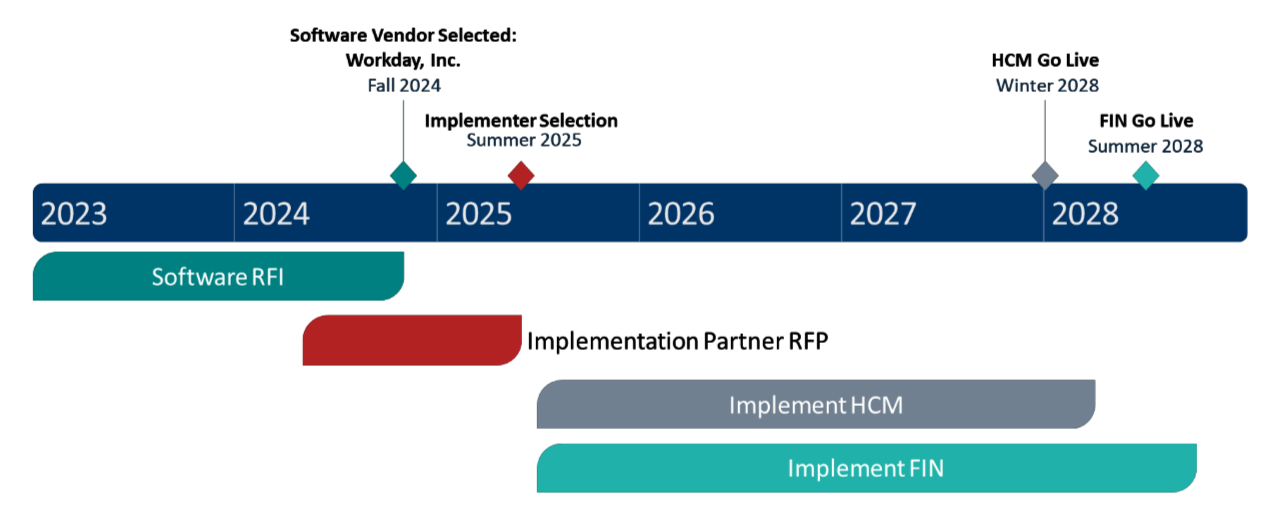

The current Oracle systems, including PeopleSoft and OneUSG, will be replaced by the Workday ERP. Both the Human Capital Management (HCM) component and the Financials (FIN) component are expected to be fully implemented by Summer 2028.

A public program launch will take place in early April. This event will be open to all USG personnel and will provide an overview of the Unified ERP program. More updates on the launch and project progress will be shared from the Project Leadership Team via this website and the Weekly Feed.
Introduction to Unified ERP Program (PDF)KSU Project Team
The Unified ERP Institutional Steering Committee is led by Executive Sponsor, Dr. Lesley Netter-Snowden, Executive Vice President and Chief Business Officer, and is made up of:
- Aaron Streimish, Vice President of Information Technology and Chief Information Officer
- Ryan McLemore, Vice President of Finance and Chief Financial Officer
- Karen McDonnell, Vice President of Human Resources and Chief Human Resources Officer
- Lynn Lamanac, Assistant Vice President of Faculty and Academic Services
- Julie Page, Executive Director of Strategic Initiatives and Lead ERP Project Manager
- Kelly Francis, Change Management Manager and ERP Institutional Change Manager
The Project Leadership Team is led by Julie Page and will include:
- Chris Fuller, Human Resources and Financial Business Suite Project Manager
- Kristen Ciarochi, Technical Business Suite Project Manager
- Kelly Francis, Change Management Manager
There are several Financial, HR, and Technical Workstreams with multiple people simultaneously working on this project across several departments. These include:
-
HCM/Payroll Workstreams
- Absence Management
- Benefits Administration
- Commitment Accounting/Labor Distribution/Position Control
- Compensation Management
- Faculty Event Management
- Human Capital Management
- Learning Management
- Payroll
- Recruitment
- Talent Optimization
- Time Tracking
-
Financial Workstreams
- Accounts Payable
- Accounts Receivable
- Asset Management
- Banking and Settlement
- Core GL/Cost Allocations
- Grants
- Inventory
- Planning and Budgeting
- Projects
- Travel and Expenses
-
Procurement Workstreams
- Catalog
- Contract Management
- P-Card
- Procurement
- Strategic Sourcing
- Supplier Management
-
Technical Workstreams
- Data Conversions
- Integrations
- Legacy System Sunsetting
- Reporting and Analytics
- Security and Access
- Service Management
- User Experience
For further assistance, contact the ERP team at ksuerpquestion@kennesaw.edu.
Change Champion Network: Role Profile
To ensure local needs, diverse departmental perspectives, and operational realities are represented, KSU ERP Project Team is launching the KSU Change Champion Network. We are recruiting dedicated staff and faculty champions from every academic department and operational unit across campus.
-
Who is an “ideal candidate”
A Change Champion serves as the vital bridge between the ERP project team and their respective department or operational unit. The ideal candidate is not necessarily a technical expert or senior supervisor, but someone who is trusted by colleagues, enthusiastic about campus improvement, and proactive about sharing information. -
Responsibilities: Approximately 4 hours per month
- Two-Way Communication: Share accurate project updates, milestone alerts, and key decisions to departmental colleagues; relay questions, rumors, and localized anxieties back to the project team.
- Process Advocacy & Culture: Champion modernized business processes and communicate potential issues to project team.
- Participation in monthly Change Champion Network call.
- Feedback & Readiness Sensing: Help assess local operational readiness, track sentiment, and identify unique departmental workflows or potential pain points.
- Post-Go-Live Super-User Liaison: Act as an approachable first point of contact within the department during go-live.
-
Personal Characteristics
- Respected Peer & Connector: High informal influence and credibility among peers
- Active Listener & Empathetic Communicator: Able to listen without judgment to colleagues' apprehensions and translate technical ERP concepts into day-to-day departmental impacts.
- Constructive Problem-Solver: Focuses on solutions and adaptability rather than lamenting obsolete legacy workarounds.
- Curious & Tech-Positive: Comfortable navigating digital systems, enthusiastic about learning new software, and patient when guiding others.
- Departmental Acumen: Understands the rhythm, peak operational periods (e.g., registration, fiscal year-end, grading deadlines), and typical workflow pinch-points of their specific unit.
-
What's In It for You
Direct Access & Voice: Early visibility and direct access to project leadership to influence campus adoption.
Professional Development: Valuable cross-functional experience.
Institutional Visibility: Recognition from executive leadership and inclusion in campus-wide transformation showcases.
Advance access to information and update on the Unified ERP Project.
Next Steps & Selection Process
Submission Window: Applications are reviewed on a rolling basis, with an initial review deadline of Friday, December 18, 2026.
Departmental Balance Review: The OCM team evaluates submissions to ensure equitable representation across schools, administrative units, and functional disciplines.
Notification & Welcome: Selected Champions and their supervisors will receive welcome packets and calendar invitations for the Change Champion Onboarding & Kickoff Workshop scheduled for Monday, January 11, 2027.
Unified ERP Project Launch Meeting - April 16, 2026
